Project management assignment: Statement of Work for Cruise Terminal

Question

Task: You are required to prepare a Statement of Work (SOW) based on your tender for the contract to build the new Sydney Cruise Terminal in this project management assignment.

Answer

Introduction
The Statement of Work has been prepared that takes into account all aspects of the tasks involved in completing the construction of the Cruise Terminal. At the beginning of construction, it is essential to check the site where the terminal is to be constructed. The site must be durable enough to withstand the heavy weight after the terminal is constructed. Also, these must be determined after conducting feasibility test for the site. After checking the site, ordering the raw materials and appointing the workers, the next task is to start the construction of the terminal. While the construction is being done, it is essential to keep a check on all aspects of the construction and a separate team must be appointed for it.The different parties involved are the contractor, the workers, the engineers, the supervisors and the project management team. Also, the project manager, leader and officers are present.
The objectives of the project are as follows-

  • To complete the inspection of site within the specified time.
  • To acquire necessary materials for the construction on time.
  • To appoint workers for constructing the terminal on time.
  • To complete the construction of the terminal within the specified time period.
  • To check the durability and strength of the constructed terminal.
  • To obtain the feasibility certificate from the concerned authorities.

ScopeofWork

  • Inspecting the site where the cruise terminal will be constructed- At the beginning of construction, it is essential to check the site where the terminal is to be constructed. The site must be durable enough to withstand the heavy weight after the terminal is constructed. Also, these must be determined after conducting feasibility test for the site.This must be done efficiently and systematically(Bu et al, 2020).
  • Acquisition of necessary materials for construction- After conducting feasibility tests for the site, it is essential to place order for the materials required at the time of construction after conducting thorough study of the material requirement. The material to be used must be of good quality and must ensure higher durability of the Cruise terminal to be constructed.This must be done efficiently and systematically.
  • Appointing workers for construction of the cruise terminal- After checking the site and ordering the raw materials, it is necessary to appoint workers who will be constructing the terminal. The team of workers must be efficient, productive and professional.This must be done efficiently and systematically(Cheng, Gong and Li, 2020).
  • Construction of the terminal-After checking the site, ordering the raw materials and appointing the workers, the next task is to start the construction of the terminal. While the construction is being done, it is essential to keep a check on all aspects of the construction and a separate team must be appointed for it.This must be done efficiently and systematically.
  • Checking the strength, durability and other aspects of the terminal after its construction-After the terminal is constructed, several durability checks, tests related to external and internal checks etc., must be conducted.This must be done efficiently and systematically(Cheng, Gong and Li, 2020).
  • Obtaining the feasibility certificate- After all the tests have been conducted, it is essential to obtain a feasibility certificate from the concerned authorities. This must be done efficiently and systematically(Cheng, Gong and Li, 2020).

Location
The location of the terminal should be such that it is easily assessable by the members of the cruise as well as the passengers. It should also be closely located to all the amenities. Also, the site where the terminal will be constructed must be a feasible one and must be finalized after conducting a feasibility test. The location of construction of terminal is the Port Botany, so appropriate location tests must be conducted(Cheng, Gong and Li, 2020).

Maintasks
The main tasks as identified in the scope of work can be broken down as follows-

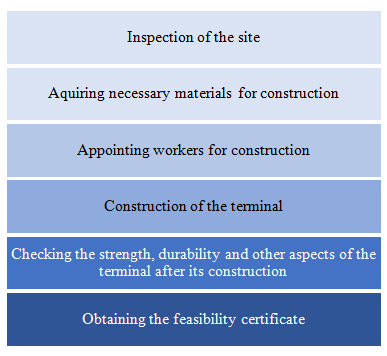

project management assignment Break up of Tasks

Figure 1- Break-up of Tasks
(Developed by the Author)

• Inspecting the site where the cruise terminal will be constructed- It can be subdivided into the following tasks-

  • Conducting the feasibility test for the site.
  • Conducting the durability test for the site.
  • Conducting the foundation test.

• Acquisition of necessary materials for construction-

  • Placing orders for the materials required.
  • Conducting quality test of the materials.
  • Checking the material specifications.
  • Checking durability of the material(Lei and Mei, 2020).

• Appointing workers for construction of the cruise terminal-

  • Contracting workers.
  • Contracting engineers.
  • Ensure that the workers areefficient, productive and professional.

• Construction of the terminal-

  • Regularly monitoring the construction.
  • Conducting intermediate inspections.
  • Keeping a track of all the activities conducted(Li, 2019).

• Checking the strength, durability and other aspects of the terminal after its construction

  • Conducting internal and external checks.
  • Conducting durability and longevity tests.

• Obtaining the feasibility certificate- After all the tests have been conducted, it is essential to obtain a feasibility certificate from the concerned authorities.

Actions required

  • Regular monitoring
  • Regular inspections
  • Detailed analysis of the progress of construction
  • Performance of the workers and engineers must be analyzed
  • Requirements of materials must be monitored

Milestones
Defining the timeline

The time limit can be shown as follows-

Tasks

Week

1

2

3

4

5

6

7

8

9

10-46

47-50

51 and 52

53 and 54



Inspection of the site



































Conducting the feasibility test and durability test for the site





































Conducting the foundation test



































Aquiring necessary materials for construction



































Appointing workers for construction



































Contracting engineers



































Construction of the terminal



































Checking the strength, durability and other aspects of the terminal after its construction



































Obtaining the feasibility certificate



































Submitting the final project





































Completion of every task
From the above timeline, it can be analyzed that several tasks can be completed in the following time-

  • Inspection of the site- Week 1
  • Conducting the feasibility test and durability test for the site-Week 1
  • Conducting the foundation test- Week 2 and 3
  • Acquiring necessary materials for construction- Week 4 and 5
  • Appointing workers for construction- Week 6 and 7
  • Contracting engineers- Week 8 and 9
  • Construction of the terminal- Week 10-46
  • Checking the strength, durability and other aspects of the terminal after its construction- Week 47-50
  • Obtaining the feasibility certificate- Week 51 and 52
  • Submitting the final project- Week 52 and 54

Deliverables

List of Deliverables

Due Date

Mode of Assessment by the Authority

Schedule of Deliverables

Inspection of the site

7.1.2021

Regular Inspections

Specified time limit

Conducting the feasibility test and durability test for the site

7.1.2021

Feasibility Test

Specified time limit

Conducting the foundation test

21.1.2021

Foundation Test

Specified time limit

Acquiring necessary materials for construction

5.2.2021

Regular Inspections

Specified time limit

Appointing workers for construction

19.2.21

Regular Inspections

Specified time limit

Contracting engineers

5.3.2021

Regular Inspections

Specified time limit

Construction of the terminal

1.11.2021

Regular monitoring and inspection

Specified time limit

Checking the strength, durability and other aspects of the terminal after its construction

14.11.2021

Durability Test

Specified time limit

Obtaining the feasibility certificate

14.12.2021

Regular monitoring and inspection

Specified time limit

Submitting the final project

31.12.2021

Regular Inspections

Specified time limit

Schedule

  • Detailsofvendors- The vendors and suppliers are fixed on a contractual basis. They will deliver the materials 2 days after placing the order and any defective material will be returned to them. Contract of supplying materials are given to Construction Materials Ltd(Wang, Luo and Lin, 2019, July).
  • Goals- The goal is to ensure that all the activities are completed within the scheduled time frame. Ensuring this will help in early or timely completion of the construction. The goal is to ensure that the terminal constructed is of good quality and it passes all the durability tests that are to be conducted.
  • Kicking ofperiod- The kicking period is planned to be one year after which the constructing will be completed with a more rapid speed and more efficiency.A superior quality and efficient cruise terminal will be delivered. It will be delivered within the specified time limit of 31st December, 2021. The completion of all the tasks within the specified time limit and as per the specified standards will be considered as milestones and achievements.

Standards
The performance will be measured on the basis of certain predefined standards. These standards are as follows-

  • Standards relating to timely inspection
  • Standards relating to regular monitoring(Wang, 2019).
  • Standards relating to the completion time of ach activity
  • Standards relating to the quality of materials used
  • Standards relating to the quality of each activity that has been conducted
  • Standards relating to performance of the workers and engineers
  • Standards relating to the usage of materials(Ye et al, 2019).

All these standards are fixed as per the previous construction experiences. The performance will be measured by experts who will be entrusted the task of measuring the current performance using several tools and equipment and they will then compare the actual performance with the standards set to find the deficiencies, if any. Then the corrective measures will be taken.

SuccessCriteria
Milestones and Achievements

The completion of all the tasks within the specified time limit and as per the specified standards will be considered as milestones and achievements. Emphasis is laid on the quality and procedure of construction in order to achieve these milestones. Also, more emphasis has been laid on completing the entire construction within the specified time frame and specified resources.

Budget

Activity

Budget

Inspection of the site



$100,000

Conducting the feasibility test and durability test for the site



$200,000

Conducting the foundation test



$200,000

Acquiring necessary materials for construction



$5,00,0000

Appointing workers for construction



$10,00,000



Contracting engineers



$10,00,000

Construction of the terminal



$1,00,00,000

Checking the strength, durability and other aspects of the terminal after its construction



$500,000

Obtaining the feasibility certificate



$400,000

Submitting the final project

$200,000



Budget Outline
The budget comprises of specific activities and the estimated expenditure for each of the activities. The budget is as follows-

Activity

Budget

Inspection of the site



$100,000-$200,000

Conducting the feasibility test and durability test for the site



$200,000-$300,000

Conducting the foundation test



$200,000-$200,000

Acquiring necessary materials for construction



$5,00,0000-$6,00,0000

Appointing workers for construction



$10,00,000-$11,00,000





Contracting engineers



$10,00,000-$11,00,000



Construction of the terminal



$1,00,00,000-$1,20,00,000

Checking the strength, durability and other aspects of the terminal after its construction



$500,000-$500,000

Obtaining the feasibility certificate



$400,000-$400,000

Submitting the final project

$200,000-$300,000



Statement
A superior quality and efficient cruise terminal will be delivered. It will be delivered within the specified time limit of 31st December, 2021.The completion of all the tasks within the specified time limit and as per the specified standards will be considered as milestones and achievements. A final quality check will also be conducted that will assure regarding the quality of the cruise terminal.

References
Bu, N., Kong, H., Barry, N.J., Sun, N., Yin, Z. and Yu, J., 2020. A Numerical Study on the Competitiveness of China's Cruise Tourism under Economic Differences. Journal of Coastal Research, 103(SI), pp.1116-1119.

Cheng, Z., Gong, L. and Li, C., 2020. Construction Practice of Cruise Port Construction. In Design and Practice of Cruise Ports (pp. 277-316). Springer, Singapore.

Cheng, Z., Gong, L. and Li, C., 2020. Cruise. In Design and Practice of Cruise Ports (pp. 13-26). Springer, Singapore.

Cheng, Z., Gong, L. and Li, C., 2020. Site Selection of Cruise Terminals. In Design and Practice of Cruise Ports (pp. 107-126). Springer, Singapore.

Cheng, Z., Gong, L. and Li, C., 2020. Terminal Buliding. In Design and Practice of Cruise Ports (pp. 195-225). Springer, Singapore.

Lei, S. and Mei, J., 2020. A Study on the Development Path of Supporting Industrial Park of Cruise Shipbuilding and Repair Industry in Shanghai. In Report on the Development of Cruise Industry in China (2019) (pp. 207-215). Springer, Singapore.

Li, Y., 2019. Cruise Ship Dock Landscape Design Based on Figure-ground Relation. Journal of Coastal Research, 94(SI), pp.547-551.

Wang, C., Luo, Z. and Lin, H.X., 2019, July. Application of real-time simulation in design of Panama Amador Cruise Terminal Project. In The 29th International Ocean and Polar Engineering Conference. International Society of Offshore and Polar Engineers.

Wang, H., 2019. Analysis on the Construction and Operation of Cruise Ports in China in 2017–2018. Report on the Development of Cruise Industry in China (2018), p.271.

Ye, X., Wang, X., Wang, Y., Luo, Y., Yang, G. and Sun, R., 2019. Design Features and Construction Enlightenments of Oasis-Class Luxury Cruise Ships. In Report on the Development of Cruise Industry in China (2018) (pp. 201-218). Springer, Singapore.

NEXT SAMPLE

Related Samples

Question Bank

Looking for Your Assignment?

Search Assignment
Plagiarism free Assignment

FREE PARAPHRASING TOOL

PARAPHRASING TOOL
FREE PLAGIARISM CHECKER

FREE PLAGIARISM CHECKER

PLAGIARISM CHECKER
FREE PLAGIARISM CHECKER

FREE ESSAY TYPER TOOL

ESSAY TYPER
FREE WORD COUNT AND PAGE CALCULATOR

FREE WORD COUNT AND PAGE CALCULATOR

WORD PAGE COUNTER



AU ADDRESS
9/1 Pacific Highway, North Sydney, NSW, 2060
US ADDRESS
1 Vista Montana, San Jose, CA, 95134
ESCALATION EMAIL
support@totalassignment
help.com
